đ Cost and Schedule Integration in EVMS: The Backbone of Program Performance
In the world of Earned Value Management Systems (EVMS), one principle separates compliant systems from high-performing ones:
đ Cost and schedule integration.
It's more than just an EIA-748 guidelineâit's the spine that connects technical execution with financial performance. When integration fails, even compliant-looking systems become liabilities. When it works, EVMS becomes the engine that drives mission success.
Across major aerospace, defense, space, and DOE programs, Iâve seen both sides. This article lays out what real integration looks like, where it breaks down, and how to fix itâgrounded in lessons learned from the trenches.
đ What Integration Actually Means
In a truly integrated system, your:
Planned Value (PV) â formerly BCWS
Earned Value (EV) â formerly BCWP
Actual Cost (AC) â formerly ACWP
...are all structurally and logically tied to your Integrated Master Schedule (IMS).
â Each Control Account has corresponding IMS activities
â Work Packages are driven by those schedule activities
â EV is objectively based on actual schedule progressânot estimates, intuition, or convenience
If EV is entered manually in the cost system without being tied to actual task completion in the IMS, you donât have integrationâyou have performance theater.
â ïž Why Integration Fails (Even in âCompliantâ Systems)
From billion-dollar primes to smaller emerging players, the failure points are surprisingly common:

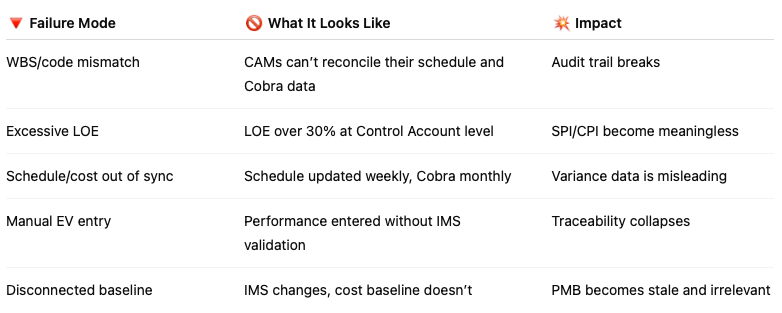

Even when EVMS is technically âvalidated,â these integration gaps expose you to CARs, data distrust, and program overruns.
đ ïž Deltek Cobra: Integration Enabler or Risk Vector?
Iâve implemented Cobra across multiple programsâitâs a powerful engine, but it doesnât automatically give you integration.
â What Cobra does well:
Time-phased cost planning
Robust variance and forecast analysis
Structured Work Package and Control Account management
â ïž Where integration breaks:
While Cobra supports integration with scheduling tools (Primavera P6, Deltek Open Plan, MS Project) via Integration Wizard, API, or Excel, it doesnât enforce traceability.
If schedule activity IDs, mapping codes, or milestone logic arenât actively maintained, Cobra will still import statusâbut it may no longer reflect real progress.
Performance data can become detached from the IMS, giving a false sense of control.
đ Cobra will accept whatever itâs fedâdiscipline is the difference between valid data and misleading metrics.
đ What EIA-748 Expects (In Plain English)
The EIA-748 guidelines lay out a clear vision for integration:
đ Guideline 6 â Your IMS must reflect the actual sequence and scope of work, tied to your Control Accounts
đ Guideline 8 â The PMB must be based on time-phased budgets tied to the schedule
đ Guideline 10 â Use objective EV techniquesâLOE only when unavoidable
đ Guidelines 22 & 23 â Variance and EAC analysis must tie back to real drivers across cost and schedule
These arenât theoreticalâthey show up in every IBR, every surveillance review, and every DOE O 413.3B-based project evaluation.
đ§ What DCMA and DOE PM-30 Reviewers Are Really Looking For
Whether you're preparing for a formal IBR or ongoing surveillance, hereâs what the government is watching for:
đ Schedule-to-Cost Linkage â Can you trace every Work Package back to IMS activities?
đ CAM Ownership â Can your CAMs explain how EV is earned from the schedule?
đ Common Cadence â Are IMS and Cobra status updates aligned in timing?
đ Baseline Discipline â Are changes to schedule logic or milestones reflected in Cobraâs cost baseline?
Theyâre not just looking for complianceâtheyâre looking for credibility. If your schedule says youâre behind but Cobra shows earned value⊠somethingâs off, and theyâll dig until they find it.
đ Best Practices That Actually Work
Hereâs what Iâve helped implement in successful programsâand what I recommend every time:
đ· 1. Let the IMS Drive the System
If the schedule isnât updated, EV shouldnât move. Period.
đ· 2. Code Activities to Work Packages
Use consistent fields (WP ID, EVT, CA ID) to ensure traceability between IMS and Cobra.
đ· 3. Minimize LOE
Keep LOE under 25â30% and use it only where work cannot be discretely measured.
đ· 4. Status in Sync
IMS and Cobra must be updated in the same cycle. Disconnects = distrust.
đ· 5. Empower Your CAMs
Train them to own both their schedule and their cost performance. If they donât, your integration is already failing.
đ§ Integration Is a Leadership Standard, Not Just a Technical One
The best EVMS environments Iâve seenâfrom launch vehicles to nuclear systemsâshared one thing in common:
Culture
CAMs werenât just reviewersâthey were owners. Schedule and cost analysts werenât siloedâthey were partners. Integration wasnât a goalâit was a habit.
In the worst environments? The IMS was a decoration. The numbers were gamed. Nobody trusted the data, and leadership stopped using EVMS altogether.
â Final Word
EVMS isn't about the toolsâitâs about the linkage. Itâs not about checking a boxâitâs about protecting your program. And itâs not just about passing an IBRâitâs about owning your baseline.
Cost and schedule integration isnât a milestone. Itâs a mindset.
If you're standing up a new EVMSâor trying to salvage one that's driftingâstart here. Start with the truth. And build the kind of system leadership can trust.
đ Need help integrating your cost and scheduleâand building a credible, audit-ready EVMS? At Elixir Value Management Systems, Inc., we help government contractors develop fully integrated EVMS solutions that support mission success and withstand compliance scrutiny.
